Build Over Sewer Options: Detailed Solutions for Safe Construction
Constructing over or near a sewer presents unique challenges, particularly for homeowners, developers, or small coastal communities like a city of 15,000 people. Sewers, whether private or public, are vital infrastructure, and building over them requires careful planning to ensure structural integrity, regulatory compliance, and future access for maintenance. This blog post dives into the options for building over sewers, with a deep focus on sewer diversion, concrete encasement, steel sleeving, and polymer relining, alongside the critical role of surface load dispersal and the heightened stress on shallow pipes.
PIPINGCIVIL DESIGNWASTEWATER
6/4/20259 min read


Sewers, especially public ones managed by water authorities, require protection to prevent damage from construction or surface loads. Building over a sewer without proper measures can lead to pipe failure, blockages, or costly repairs. Shallow sewers (typically less than 1.2 meters deep) are particularly vulnerable to stress from above-ground structures due to their proximity to surface loads. Regulations in regions like the UK, Australia, or the US often mandate approvals from water authorities to ensure sewers remain functional and accessible.
Surface Loads and Sewer Depth
Surface loads from buildings, vehicles, or heavy equipment transfer stress to underground pipes. The deeper a sewer is buried, the more the soil disperses these loads, reducing pressure on the pipe. For example:
Shallow Sewers (0.5–1.2 meters): These experience high stress from surface loads due to limited soil cover. A 1-ton load on the surface can exert significant pressure (e.g., up to 50 kPa) on a pipe at 0.5 meters, risking cracks or collapse, especially in older clay or concrete pipes.
Deeper Sewers (2–3 meters): Soil disperses loads more effectively, reducing pressure to 5–10 kPa for the same 1-ton load, making deep sewers less vulnerable.
Load Dispersal: Soil type matters—sandy soils disperse loads more evenly than clay, which can concentrate stress. Foundations like slabs or footings increase load distribution but can still stress shallow pipes without proper mitigation.
Shallow sewers, common in older urban or coastal areas, require robust solutions to handle these stresses, making options like diversion or pipe protection critical.

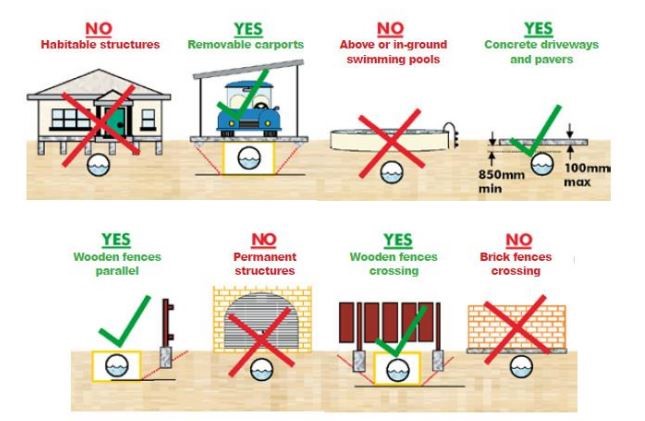

Build Over Sewer Options
Below are the primary options for building over sewers, with detailed explanations of diversion, concrete encasement, steel sleeving, and polymer relining, alongside other approaches.
1. Sewer Diversion
The diversion process involves significant excavation to create a new trench for the replacement pipes, which are often made of durable materials like PVC or HDPE to ensure longevity. The cost can range from $10,000 to over $100,000, depending on factors like the length of the sewer (e.g., 50–100 meters), its depth (1–3 meters), and site-specific challenges such as rocky soil or coastal erosion risks. In coastal areas, additional considerations like tidal influences or environmental regulations may increase complexity and cost.
The diversion must be approved by the local water authority, ensuring compliance with hydraulic and environmental standards. After excavation and pipe installation, the site is backfilled, and surfaces are restored. Finally, sewer records are updated to reflect the new configuration. While costly and time-intensive (taking 6–12 months for planning and execution), diversion eliminates future access issues, allows unrestricted building design, and reduces long-term maintenance risks, making it a preferred choice for significant projects.
Process:
Survey and Design: A surveyor maps the sewer’s path using CCTV and topographic surveys. Engineers design a new route, typically avoiding the building site while maintaining flow gradients (e.g., 1:40 for gravity sewers).
Excavation and Re-Piping: Contractors excavate a new trench, install replacement pipes (often PVC or HDPE for durability), and connect to existing manholes or inspection chambers.
Approval: Submit plans to the water authority (e.g., under Section 185 of the UK’s Water Industry Act or equivalent regulations). Approvals ensure the new route meets hydraulic and environmental standards.
Restoration: Backfill trenches, restore surfaces, and update sewer records.
Costs: $10,000–$100,000+, depending on sewer length (e.g., 50–100 meters), depth (1–3 meters), and site constraints like rocky soil or coastal erosion risks.
Best For: Large developments, deep sewers (>1.5 meters), or projects where building over the sewer is impractical due to high surface loads or access needs.
Pros: Eliminates future access issues, allows unrestricted building design, and reduces long-term maintenance risks.
Cons: High cost and time-intensive (6–12 months for planning and execution). Coastal areas may face additional challenges due to tides or environmental regulations.
2. Concrete Encasement
Concrete encasement involves surrounding the sewer pipe with a reinforced concrete layer to protect it from surface loads and construction impacts. The process starts with a CCTV survey to confirm the pipe’s condition, as older clay pipes may need replacement to withstand encasement stresses. Contractors excavate around the pipe, creating a trench typically 1–2 meters wide to access the section beneath the planned structure.
A concrete sleeve, usually 150–300 mm thick and reinforced with rebar, is poured around the pipe, extending beyond the building footprint to distribute loads effectively. The concrete used is typically C20–C30 grade, providing sufficient strength to withstand surface loads of up to 100 kPa, which is critical for shallow sewers under structures like home extensions or garages. After pouring, the concrete cures for 7–28 days, followed by backfilling with compacted soil to restore the site.
Costs for concrete encasement range from $2,000 to $10,000 per 10-meter section, depending on pipe diameter and site access. This method is ideal for shallow sewers (<1.2 meters) where diversion is cost-prohibitive. It strengthens the pipe against high surface loads but can limit future access, requiring careful planning to maintain manholes or inspection chambers. In coastal areas, corrosion-resistant additives may be included in the concrete to combat saline soil conditions.
Process:
Assessment: Conduct a CCTV survey to confirm the pipe’s condition (e.g., no cracks or leaks). Older clay pipes may need replacement before encasement.
Excavation: Dig around the pipe to expose the section under the build area, typically 1–2 meters wide.
Encasement: Pour a concrete sleeve (e.g., 150–300 mm thick, with rebar for added strength) around the pipe, ensuring it extends beyond the building footprint to distribute loads.
Curing and Backfill: Allow concrete to cure (7–28 days), then backfill with compacted soil to restore the site.
Technical Details:
Concrete strength: Typically C20–C30 grade for durability.
Load capacity: Can withstand surface loads up to 100 kPa, ideal for shallow sewers under light structures like extensions.
Access: Manholes must remain accessible, often requiring raised covers or new chambers.
Costs: $2,000–$10,000 per 10-meter section, depending on pipe diameter and site access.
Best For: Shallow sewers under small to medium structures (e.g., home extensions or garages) where diversion is too costly.
Pros: Enhances pipe strength, cost-effective compared to diversion, suitable for high-load areas.
Cons: Limits future pipe access, adds construction time, and may not suit large-diameter sewers (>300 mm).
3. Steel Sleeving
Steel sleeving encases the sewer in a protective steel pipe to shield it from surface loads and external damage, particularly in corrosive environments like coastal regions. The process begins with a CCTV survey to assess the pipe’s condition and diameter (typically 100–600 mm). A steel sleeve, approximately 50 mm larger in diameter than the sewer, is slid over the pipe or installed as split sleeves clamped and welded for stability. The sleeve is bedded on compacted gravel or concrete to prevent settling, and gaps are filled with grout or epoxy to ensure a water-tight seal.
The steel used is often stainless or galvanized to resist corrosion, with additional coatings or cathodic protection applied in saline coastal soils. Steel sleeves can handle high surface loads (up to 150 kPa), making them suitable for shallow sewers under driveways or small buildings. Costs range from $3,000 to $15,000 per 10-meter section, depending on pipe size and material quality.
This method is effective for short sewer sections and allows some maintenance access, but it’s costly for longer runs and requires precise installation to avoid damaging the existing pipe. In coastal cities, steel sleeving is favored for its durability against corrosion, ensuring long-term protection.
Process:
Survey: Use CCTV to assess pipe condition and diameter (typically 100–600 mm).
Sleeve Installation: Slide a larger-diameter steel pipe (e.g., 50 mm larger than the sewer) over the existing pipe or install split sleeves clamped around it. Weld or bolt the sleeve for stability.
Support: Bed the sleeve on compacted gravel or concrete to prevent settling.
Sealing: Use grout or epoxy to fill gaps between the sleeve and pipe, ensuring water-tightness.
Technical Details:
Steel grade: Often stainless or galvanized steel to resist corrosion, especially in coastal areas with saline soil.
Load capacity: Can handle high surface loads (e.g., 150 kPa), ideal for shallow sewers under driveways or small buildings.
Corrosion protection: Apply coatings or cathodic protection in corrosive environments.
Costs: $3,000–$15,000 per 10-meter section, depending on pipe size and sleeve material.
Best For: Shallow sewers in high-load areas or where corrosion is a concern (e.g., coastal cities).
Pros: Durable, allows some access for maintenance, and suitable for small sections.
Cons: Expensive for long runs, requires precise installation to avoid pipe damage.
4. Polymer Relining
Polymer relining reinforces an existing sewer by inserting a flexible, resin-impregnated liner, creating a new pipe within the old one without excavation. After a CCTV survey and pipe cleaning, a felt or fiberglass liner soaked in epoxy or polyester resin is inserted using air or water pressure (Cured-In-Place Pipe, or CIPP, method). The liner is cured using heat, UV light, or ambient conditions over 4–24 hours, forming a rigid, seamless pipe. Robotic cutters reopen connections to laterals or manholes.
The liner, typically 3–10 mm thick, increases the pipe’s strength to handle moderate surface loads (30–50 kPa), making it suitable for shallow sewers under light structures. It’s highly resistant to corrosion, ideal for coastal areas with saline groundwater. Costs range from $1,500 to $8,000 per 10-meter section, depending on pipe size and access.
Polymer relining is minimally invasive, fast (1–2 days), and extends pipe life by 50+ years, but it slightly reduces pipe diameter (2–5%) and may not suit severely collapsed pipes. It’s an excellent choice for aging sewers in urban or coastal settings where excavation is impractical.
Process:
Inspection: Conduct a CCTV survey to check for cracks or blockages, cleaning the pipe as needed.
Liner Insertion: Insert a felt or fiberglass liner soaked in epoxy or polyester resin into the pipe using air or water pressure (Cured-In-Place Pipe, or CIPP, method).
Curing: Cure the liner with heat, UV light, or ambient conditions (4–24 hours), forming a rigid, seamless pipe within the old one.
Reconnection: Cut openings for laterals or manholes using robotic cutters.
Technical Details:
Liner thickness: 3–10 mm, depending on pipe diameter and load requirements.
Load capacity: Increases pipe strength to handle moderate surface loads (e.g., 30–50 kPa), suitable for shallow sewers under light structures.
Corrosion resistance: Ideal for coastal areas with saline groundwater.
Costs: $1,500–$8,000 per 10-meter section, depending on pipe size and access.
Best For: Aging or damaged shallow sewers where excavation is impractical (e.g., under existing buildings or roads).
Pros: Minimal disruption, fast installation (1–2 days), and enhances pipe lifespan by 50+ years.
Cons: Reduces pipe diameter slightly (2–5%), may not suit severely collapsed pipes.
5. Build Over Agreement
What It Is: Obtaining permission from the water authority to build over a public sewer without altering it.
Process:
Submit detailed plans, including structural calculations showing minimal load transfer to the sewer (e.g., using lightweight foundations like cantilevered beams).
Conduct a CCTV survey to confirm pipe condition.
Ensure manholes remain accessible, often using raised covers.
Load Considerations: For shallow sewers, lightweight materials or load-spreading foundations (e.g., raft slabs) are critical to reduce stress (e.g., keeping loads below 20 kPa).
Costs: $100–$1,000 for approvals, plus $1,000–$5,000 for engineering and surveys.
Best For: Small projects over shallow, small-diameter sewers (<160 mm).
Pros: Cost-effective, minimal disruption.
Cons: Limited to low-risk scenarios, restricts future pipe access.
6. Modify Building Plans
What It Is: Redesigning the project to avoid the sewer, using load-spreading techniques to minimize stress.
Options:
Relocate the building footprint.
Use piled foundations to transfer loads to deeper soil layers, bypassing the sewer.
Design around manholes to maintain access.
Load Dispersal: Piled foundations can reduce surface load on shallow sewers to near zero by transferring weight to depths of 3–5 meters.
Costs: $5,000–$20,000 for redesign and engineering.
Best For: Flexible projects where diversion or protection is too costly.
Pros: Avoids sewer modification, cost-effective for small sites.
Cons: May reduce usable space or require costly foundation designs.
Key Considerations
Sewer Depth and Load Stress: Shallow sewers (<1.2 meters) face high stress from surface loads (e.g., 50–100 kPa from a building foundation), risking failure. Deeper sewers (>2 meters) benefit from soil load dispersal, reducing stress to 5–15 kPa. Use engineering calculations to ensure loads stay within pipe tolerances (e.g., 30 kPa for clay pipes, 50 kPa for PVC).
Sewer Condition: Older clay or concrete pipes are brittle and prone to cracking under load, necessitating replacement or relining. Newer PVC or HDPE pipes are more resilient but still require protection for shallow installations.
Coastal Challenges: In a small coastal city, saline soil and groundwater increase corrosion risks, favoring steel sleeving or polymer relining. Coastal erosion may complicate diversions, requiring environmental permits.
Regulations: In the UK, water authorities like Thames Water require build over agreements for public sewers within 3 meters of a build Hawkins: Sewer Diversion
A sewer diversion, as detailed above, involves rerouting the sewer to avoid the building footprint entirely. This option is particularly suitable for larger developments or deep sewers where building over them is impractical. The process begins with a comprehensive survey, including CCTV inspections and topographic mapping, to understand the sewer’s current path and condition. Engineers then design a new route, ensuring proper flow gradients (typically 1:40 for gravity sewers to maintain efficient drainage). This new path must avoid the proposed building site and connect seamlessly to existing manholes or inspection chambers.
Steps to Build Over a Sewer
Locate and Assess: Use sewer maps and CCTV surveys to map the sewer’s path and condition.
Consult Authority: Submit plans to the water authority for approval, detailing the chosen option.
Engage Professionals: Hire engineers and contractors to design and implement solutions.
Secure Permits: Obtain approvals from water authorities and building control.
Execute and Monitor: Implement the solution, ensuring compliance and minimal sewer stress.
Post-Construction: Submit as-built drawings and schedule regular sewer inspections.
In a coastal city of 15,000, a developer planning a community center might encounter a shallow public sewer (0.8 meters deep, 150 mm diameter). A build over agreement with piled foundations could minimize load stress (e.g., <10 kPa), costing $2,000–$5,000. For a larger project over a deeper sewer (2 meters, 300 mm), diversion might be necessary, costing $20,000–$50,000 due to coastal soil challenges. Polymer relining could be a cost-effective alternative ($3,000–$10,000) for an aging shallow sewer, enhancing durability against saline corrosion.
Conclusion
Building over sewers requires strategic planning to balance structural safety, regulatory compliance, and cost. Options like sewer diversion, concrete encasement, steel sleeving, polymer relining, build over agreements, plan modifications, or adopting private sewers offer tailored solutions. For a small coastal city, where shallow sewers and corrosive soils are common, protective measures like relining or sleeving are often ideal. Early consultation with water authorities and engineers ensures a resilient, compliant project.
